Sdílet prostřednictvím


Rollup estimated and actual work using Project

TFS 2018 | TFS 2017 | TFS 2015 | TFS 2013

Because Microsoft Project has a scheduling engine, it automatically will generate a rollup of summary tasks. Rollup provides summed values of select fields for all child work items of a parent.

Important

Microsoft Project Integration and the TFSFieldMapping command are not supported for:

  • Visual Studio 2019 and Azure DevOps Office® Integration 2019
  • Azure DevOps Server 2019 and later versions, including Azure DevOps Services.

However, full support for Microsoft Excel integration is maintained and supports bulk import and update of work items. Alternatives to using Microsoft Project include the following:

There are a few items to be aware of, however, to make it work correctly. You may have to add fields to work item types (WITs) and update the Microsoft Project Mapping file. You can work in Project or TFS to structure the breakdown of work items and move seamlessly back and forth from each tool by publishing and refreshing data. After setting a baseline schedule in Project, you publish your rollup values to TFS.

With Project, you can rollup estimated, completed work or remaining work, and effort, size, or story points. By publishing the rollup values back to TFS, you can view them in work item forms, queries or on the backlog pages.

taskboard displays round-trip rollup from Project

To learn about other methods that support rollup, see Support rollup of work and other fields.

Add fields to work item types

The following default fields used to schedule work are only present on the task work item.

  • Original Estimate (Microsoft.VSTS.Scheduling.OriginalEstimate): The amount of work required to complete a task. (Agile and CMMI)

  • Completed Work (Microsoft.VSTS.Scheduling.CompletedWork): The amount of work that has been spent implementing a task. (Agile and CMMI)

  • Remaining Work (Microsoft.VSTS.Scheduling.RemainingWork): This field is used to support burndown charts.

    If your project was created using the Visual Studio Scrum process template, only Remaining Work is defined in the task.

  1. Add required fields to the WITs that will capture the rollup values.

    For example, to rollup Original Estimate or Completed Work for user stories, add the following fields to the WIT definition for user story:

    <FIELD name="Original Estimate" refname="Microsoft.VSTS.Scheduling.OriginalEstimate" type="Double" reportable="measure" formula="sum">
       <HELPTEXT>Initial value for Remaining Work - set once, when work begins</HELPTEXT>
    </FIELD>
    <FIELD name="Completed Work" refname="Microsoft.VSTS.Scheduling.CompletedWork" type="Double" reportable="measure" formula="sum">
        <HELPTEXT>The number of units of work that have been spent on this task</HELPTEXT>
    </FIELD>


    To learn more about adding fields, see Modify a field or add a custom field.

  2. Determine if you want to make rollup values read-only on the work item form.

    By making them read-only you prevent users from introducing data inaccuracies into TFS. You make fields read-only using the Control field Readonly attribute.

Update the Microsoft Project Mapping file

  1. Update the Microsoft Project Mapping file to contain the field mappings you need to support rollup. For details, see Upload or download the Microsoft Project Mapping file.

    Depending on the process template used to create your project, some of these mappings may be there already. Here's an example of fields to include:

    <Mapping WorkItemTrackingFieldReferenceName=" Microsoft.VSTS.Scheduling.OriginalEstimate" ProjectField="pjTaskBaselineWork" ProjectUnits="pjHour" PublishOnly="false" IfSummaryRefreshOnly="false" />
    <Mapping WorkItemTrackingFieldReferenceName=" Microsoft.VSTS.Scheduling.CompletedWork" ProjectField="pjTaskActualWork" ProjectUnits="pjHour" PublishOnly="false" IfSummaryRefreshOnly="false" />
    <Mapping WorkItemTrackingFieldReferenceName="Microsoft.VSTS.Scheduling.RemainingWork" ProjectField="pjTaskRemainingWork" ProjectUnits="pjHour" PublishOnly="false" IfSummaryRefreshOnly="false" />
    <Mapping WorkItemTrackingFieldReferenceName="Microsoft.VSTS.Scheduling.StartDate" ProjectField="pjTaskStart" PublishOnly="true" IfSummaryRefreshOnly="false" />
    <Mapping WorkItemTrackingFieldReferenceName="Microsoft.VSTS.Scheduling.FinishDate" ProjectField="pjTaskFinish" PublishOnly="true" IfSummaryRefreshOnly="false" />


    Don't map Original Estimate or any other field to pjTaskDuration. This mapping is not supported.

  2. If you want to map Effort, Story Points, or Size, use a pjTaskNumber field, for example:

    <Mapping WorkItemTrackingFieldReferenceName="Microsoft.VSTS.Scheduling.StoryPoints" ProjectField="pjTaskNumber12" PublishOnly="false" IfSummaryRefreshOnly="false" />

  3. Assign PublishOnly="false" and IfSummaryRefreshOnly="false" in the mapping file so that the rollup summary values are published to the TFS database.

Structure your work items to support rollup

  1. Link all work items that should support rollup using parent-child links. For example, create tasks that link to user stories.

    You can do this easily by creating tasks from the taskboard, or you can create your schedule in Project.

  2. Determine the unit of time used to track work and make sure it is used consistently across your team or organization. For example, you can track tasks using hours or days.

  3. Specify values for Original Estimate (Agile and CMMI only) and Remaining Work for each task.

    If you work in Project, specify the Duration for each task.

  4. If you want to roll up to a feature level, link user stories, or other backlog items, to features using parent-child links.

    You can quickly link items using the mapping pane.

Create a query of the work items you want to rollup

If you've created your work items in Project, then you can proceed to creating your schedule in Project.

However, if you've created your work items in TFS, your next step is to create a tree query. By viewing backlog items to tasks, you can create the query from the backlog page.

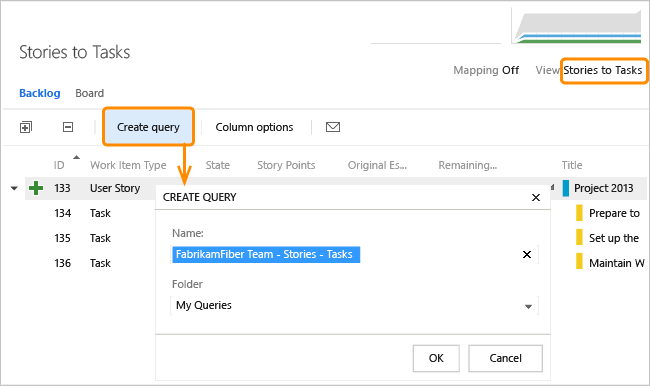

Create query from backlog page

For more information, about tree queries, see Use the query editor to list and manage queries

Create your schedule in Project

  1. If you've created your work items in Project, then skip to step 2.

    To get rollup of work items you've defined in TFS, open Project, connect to the project, and open the query you created in the last procedure.

    Connect to a project from Microsoft Project

    Project is now bound to your project. The Team Foundation Gantt view supports entry and display of several TFS fields.

    If you don't see the Team ribbon (or the Team menu if you use Project 2007) see Create your backlog and tasks using Project. To get the Team Foundation add-in, you need to have Team Explorer installed if you don't have Visual Studio installed.

  2. From the Schedule page (File>Options>Schedule) set those options that need to match with how you track work in TFS. For example, if you track work in hours, make sure that Project is set to track hours. To automate scheduling of tasks, choose Auto Scheduled.

    Schedule options

  3. Add columns to display fields that you need. For example, you might need to add columns to display Original Estimate and Completed Work. These TFS fields correspond to the Baseline Work and Actual Work fields in Project.

    To see which TFS fields are mapped, open Column Mappings.

    View which TFS fields are mapped to project fields

  4. Enter your work estimates in the Duration column, not in the Baseline Work.

Set a baseline and publish changes and rollup values to TFS

When you use Microsoft Project to create parent and child tasks, it assigns parent or summary tasks the rollup of hours or days that are defined for all its child tasks.

  1. When you have a schedule that meets your needs, set the Project Baseline to copy the values in the Duration field to the Original Estimate field.

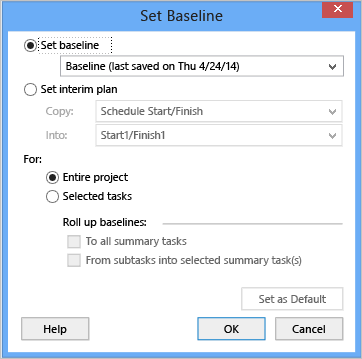

    Set baseline option

    Set baseline

  2. To publish changes you make in Project to TFS, make sure that the Publish and Refresh field is set to Yes. Set this field to No if you create milestone tasks or other tasks that aren't work item related.

  3. Publish your changes and rollup values to TFS.

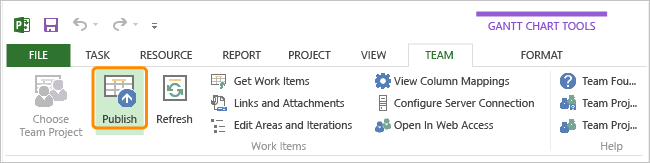

    Publish

  4. As changes occur to the schedule, you can refresh your Project plan, clear and set a new baseline, and republish the rollup values.

Q & A

Q: Where can I learn more about customizing the Microsoft Project Field Mapping file?

A: See Customize the Microsoft Project field mapping file.

Q: What's the difference between manual and automated task scheduling?

A: By using Task Mode, which is accessed through the following Ribbon menu, you have more flexibility in the way you and team members schedule tasks.

Task mode scheduling ribbon menu options

By using manually scheduled tasks, which are indicated by the Pinned task icon icon, you can manually schedule the duration and the start and finish dates for a task. Team members can place a manually scheduled task anywhere in their schedules, and Project will not move it.
